How to Buyout a $50M+ Construction Project in 3 Days Using AI
The human-first, AI-native workflow that turns 5–8 weeks of scopes into 72 hours.
Today’s Overview:
Buyout shows up when the project is already on fire. New drawings. Early schedule pressure. Owner questions. A team that’s still ramping up.
Scopes get written late at night by one person, off memory, while everyone else is fighting fires. That’s where gaps and assumptions creep in. You might not notice now. You pay for it later in RFIs, scope fights, and change orders.
Today you will get a human-first, AI-native buyout workflow. Where AI does the heavy drafting. Your team stays focused on the high-leverage work: judgment, risk, and clarity.
🏗️ PERFECT YOUR PLANNING ROUTINE WITH OUTBUILD!
Helping projects prevent delays to stay on schedule.
Outbuild is designed for one thing: to make construction scheduling simple, connected, and effective. It’s the trusted choice of top contractors. Here’s why:
✅ User-Friendly: Intuitive drag-and-drop features let your team get started immediately without any long training sessions.
✅ Collaborative: Everyone—from trade partners to PMs and PEs—can log in, plan their work, and communicate directly in one centralized platform.
✅ Integrated: Outbuild syncs effortlessly with Procore and others, keeping all your project workflows in one place.
✅ Real-time Insights: Powerful reporting and analytics track progress, delays, and resource usage, empowering you to make fast, informed decisions.
Outbuild lets you manage projects better so you can focus on what truly matters.
👉 Book a live demo (30 day free trial included). iPM subscribers get a 15% discount on the first year license.
💼 We bought out a $54M project in 3 days using AI
Filed under: Construction, Project Management, AI
Hey there,
How long does your team spend writing scope of work documents for a typical project?
If the answer is weeks, you’re not alone.
For a $50M+ million construction project, writing all the scopes normally takes 5–8 weeks of grinding through drawings, writing scopes from scratch, reviewing drafts, and chasing trade partners for comments.
My team got it done in 3 days.
We didn’t skip steps or cut any corners. We used AI for the heavy drafting, and we used the team’s judgment for decisions, gaps, and risk.
This newsletter is the full play-by-play: the steps, the time, the templates, and what we’d do differently next time.
Why traditional buyout drags
Buyout hits at the worst possible time.
The project is new. The team is ramping. The owner is already calling. The schedule is tight. Then someone has to write 20+ scopes.
That “someone” is usually the PM, working solo.
They either stare at a blank page and guess, or they pull an old scope and rewrite it line-by-line until it kind of fits.
Both approaches are slow. Both create gaps.
The bigger issue is teams treat buyout like admin work when it’s a strategy exercise.
The people with the best information aren’t in the document. Superintendents who have built it. PEs who know the coordination traps. APMs who know where money leaks. If that experience stays in heads, scopes turn into one person’s best guess.
The scopes come from one person’s memory. The change orders come from everyone else.

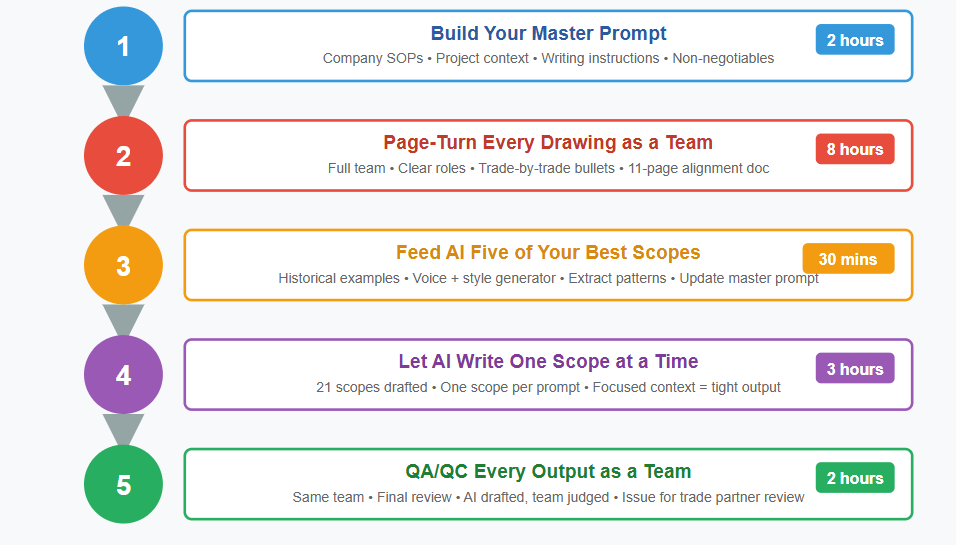

The 5-Step AI Buyout System
Here’s exactly what we did. Total team time: about 15–16 hours.
A traditional buyout on a job this size can eat 3–5 weeks. We compressed it into three days without lowering the quality bar.
Step 1: Build your master prompt (2 hours)
Before you open a single drawing set, you need to build your Master Prompt.
Think of it like onboarding a new project manager.
When you bring on a new PM, you don’t hand them drawings and say “good luck.” You give them context. Expectations. Standards. You tell them how your company operates, what “good” looks like, and what you need from them.
A master prompt is a 2-3 page document that does that for the AI.

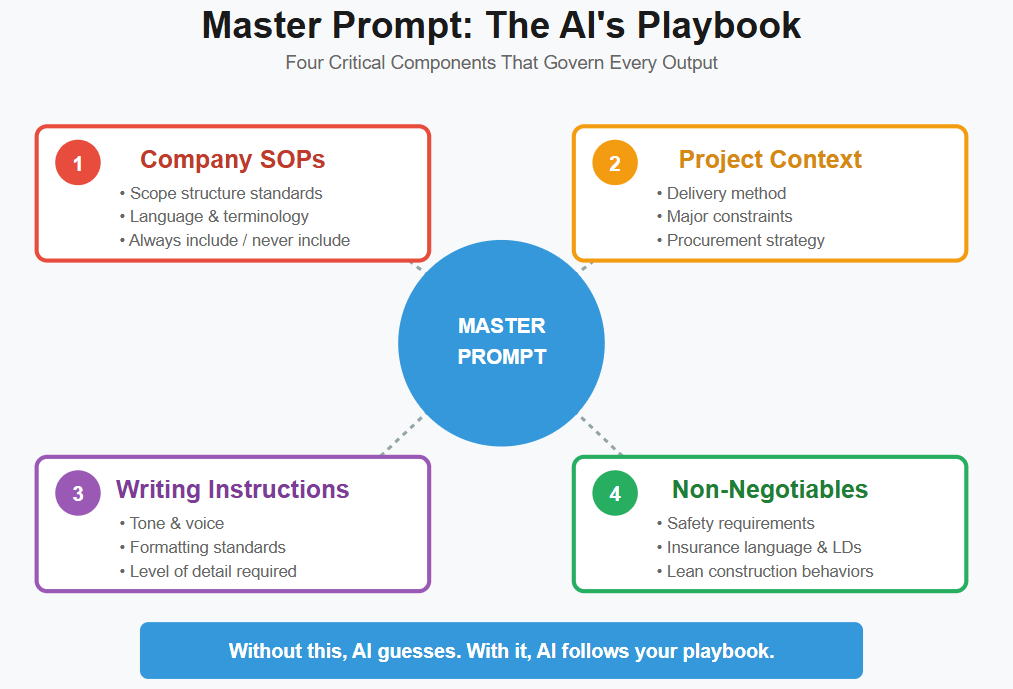

Ours covered four sections:
Company SOPs: how we structure scope docs, what language we use, what we always include, and what we never include
Project context: delivery method, major constraints, procurement strategy, and key stakeholders
Writing instructions: tone, formatting, standard clauses, and level of detail
Non-negotiables: safety requirements, insurance language, LDs, and lean behaviors
We loaded the master prompt into our Notion AI agent’s instructions. Every scope document produced from that point forward was governed by those rules.
Tool used: Notion AI ($24/month).
If you’re on Notion’s Business plan, you already have it.

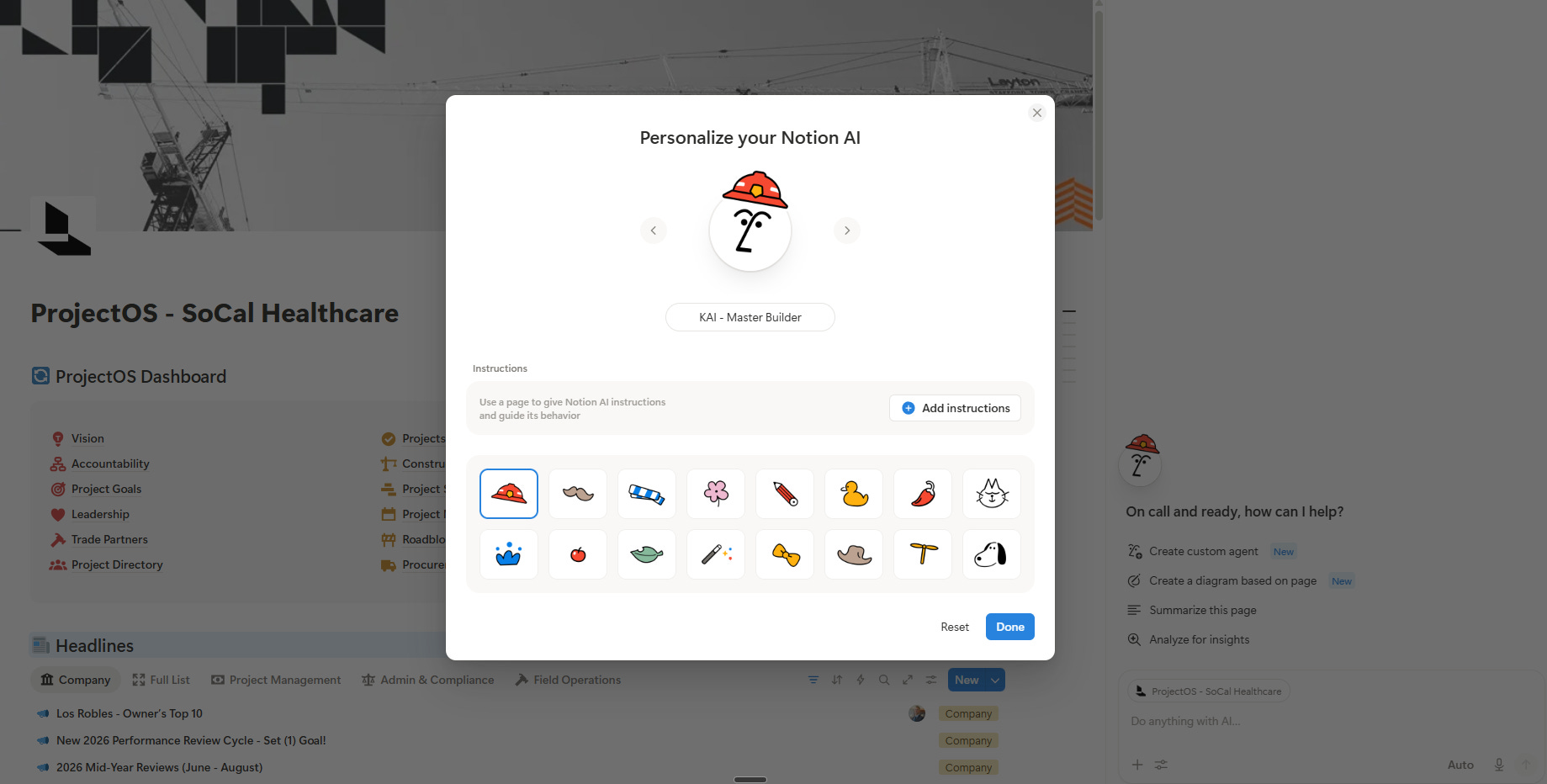

Here’s the setup: open your agent, go to its instructions, and paste your Master Prompt directly in. That one step is the difference between a highly effective output and a generic AI response. The agent now has your company’s voice, your project context, and your non-negotiables baked in — before you type a single prompt.
Without a Master Prompt, you’re asking AI to guess. With one, you’re giving it a playbook. Scopes generated without one read like generic boilerplate. Scopes generated with one read like your best work.
→ Download the Master Prompt Template: Master Prompt Template — AI Scope Writer
Step 2: Page-turn every drawing as a team (8 hours)
This is the most important step in the entire process.
And it has nothing to do with AI.
We got the full team in the room: PMs, superintendents, project engineers, APMs.
Two sessions. Four hours each.
Day 1: Architectural and Structural
Day 2: MEP and Equipment
Every drawing. Every sheet. Every detail.
We ran it with clear roles:
Sheet flipper: drives the drawing set, one sheet at a time
Screen operator: highlights live as the team calls things out (color-coded by trade)
Note taker (PE): writes bullet points into the scope alignment doc in real time
Superintendents: call out field conditions, logistics, sequencing, and risk
PM: facilitates, keeps pace, assigns follow-ups
For each trade, we answered three questions:
What scope belongs in this package?
Who picks it up — GC self-perform or subcontractor?
What are the key details, sheet references, and risk items?
Our output was an 11-page scope alignment document: trade-by-trade bullets with sheet references, logistics flags, and scope boundaries.
That work also flushed out issues early: coordination conflicts, gaps, and drawing inconsistencies.
Have those arguments in the room now, not in an OAC meeting three months from now.
Don’t skip this step. AI writes based on inputs. This is where you build the inputs.
Step 3: Feed AI five of your best scopes (30 minutes)
Before drafting a single scope, we showed the AI what “good” looks like.
We pulled five historical scopes that held up in disputes and set clear expectations.
Then we ran a voice + style generator prompt to extract the patterns: sentence structure, formatting, tone, and the clauses we repeat.
We pasted that style guide into the master prompt.
AI mirrors examples.
If you feed it your best writing, it drafts closer to your standard.
→ Download the Voice & Style Generator Prompt: Voice & Style Generator — AI Scope Writer
Step 4: Let AI write one scope at a time (3 hours)
With the master prompt loaded and the alignment document ready, we drafted one scope at a time.
Framing and Drywall
Mechanical and Plumbing
Doors, Frames, and Hardware
Flooring and Specialties
Electrical
Fire Protection
And so on…
The prompt stayed consistent:
"Write the [Trade] scope of work. They are doing [X]. Study the relevant bullets from our alignment document."
Result: 21 formatted scope documents drafted in about 2.5 hours.
In three hours, we had more usable output than a traditional process produces in three weeks.
We kept one rule: one scope per prompt.
When you ask for everything at once, the output bloats. When you focus the context, the output tightens.
Step 5: QA/QC every output as a team (2 hours)
Same team. Final review session.
Two thing happened:
The quality was high on the first pass.
The mistakes were obvious once field experience looked at it.
AI wrote clauses that sounded fine but wouldn’t work in the field. It assigned responsibilities that were technically defensible but didn’t match how we manage trade partners.
AI drafted. The team judged.
We tuned everything, then issued the scopes for trade partner review and comment.
Buyout meetings started the following week.
Three things that will trip you up
A few things will trip you up the first time. Here’s what to watch for.
AI doesn’t know what it doesn’t know. AI only works with what you give it. If it isn’t in the alignment document or the master prompt, it will either skip it or guess.
Overconfidence in the output. Step 5 isn’t optional. A human review is the filter.
Weak historical examples. Your five historical examples matter. If they’re mediocre, the drafts will be too.
Final Takeaways
If you want to run this on your next project:
Pick a project in buyout (a smaller job is a fine first run).
Build your master prompt. Use the template. Customize it. Get the template →
Schedule your page-turn sessions. Block two half-days with the core team before you touch AI.
Pull five strong historical scopes and run the voice + style generator.
Draft one scope at a time.
QA/QC as a team.
By the third project, this becomes standard work.
A few things worth knowing before you start:
No confidential project information needs to be shared with AI. Keep all inputs generic or anonymized — as we did throughout our process.
The Master Prompt is a living document. Update it as your SOPs evolve.
This process works across all delivery methods — GMP, lump sum, design-build, CM at-risk.
This is what the future of project management looks like.
AI does the writing. You do the leading. Keep that split and the process works every time.
Stop asking: “How can AI do this for me?”
Start asking: “How can AI help me do this faster?”
That question keeps you in the loop. Making decisions. Reading the room. Catching what only field experience can catch.
Until next week,
Kyle Nitchen
P.S. The Master Prompt Template and Voice & Style Generator prompt are ready for you. Grab them, customize them for your project, and run this process on your next buyout. → Master Prompt Template | Voice & Style Generator

Ready to level up? Here are 4 ways I can help you:
Get ProjectOS. The AI-powered Notion project operating system I use to manage $300M+ in projects. Set up in 1 day, not 3 years. Save 10+ hours weekly.
Join Antifragile Project Management. Leadership development course and community built on the 7 Archetypes Framework. Transform from project witness to project leader. Earn promotions and reach senior leadership levels.
Read the Book. No Bullsh*t Project: A Project Manager’s guide to successful project leadership. Available on Amazon.
Promote Your Business. Get your brand in front of 8,500+ highly engaged construction leaders and decision-makers with a 51% open rate.
